body-container-line-1

“Competitive Tendering as the Norm”: Assessing Ghana’s Amended Public Procurement Act and the Risk-Reward of Faster Procurement Cycles

Feature Article “Competitive Tendering as the Norm”: Assessing Ghana’s Amended Public Procurement Act and the Risk-Reward of Faster Procurement Cycles
TUE, 11 AUG 2026

Government has cut the tendering clock nearly in half and narrowed the door to single-source deals. The intent is sound. The test now is whether speed and scrutiny can genuinely travel together.

Ask any contractor who has bid for a national roads contract in Ghana how long they waited between submitting a tender and signing the contract, and you will usually get a sigh before an answer. Months of paperwork sit between bid opening and mobilisation, and in that stretch prices move, machinery sits idle, and financing costs quietly pile up into the eventual contract sum. That waiting period has just been legislated shorter.

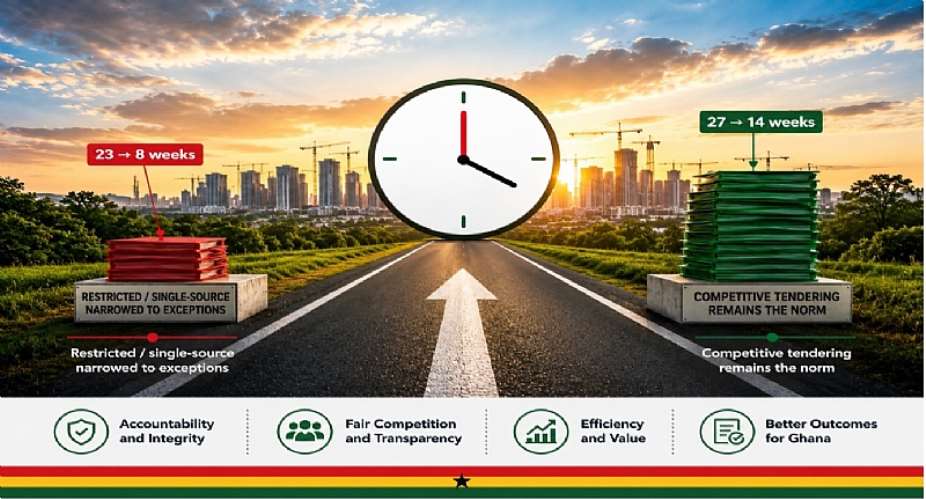

Under the amended Public Procurement Act referenced in the 2026 Mid-Year Fiscal Policy Review, the lead time for National Competitive Tendering for goods falls from twenty-three weeks to eight, and International Competitive Tendering for works comes down from twenty-seven weeks to fourteen. On paper, this is one of the more consequential procurement reforms Ghana has attempted in years. Whether it delivers on that promise, or simply pushes the same risks further down the pipeline, is the question worth sitting with.

Why the Act needed amending
The Review is candid that the earlier framework, even after previous amendments, still had gaps. It credits earlier reforms with having “improved the delivery of public projects and strengthened the management of public resources,” but adds plainly that “important gaps remain.” Government has responded by targeting three problem areas: shortening lead times, limiting single-source procurement, and tightening restricted tendering. As the Review puts it, “Competitive Tendering must remain the norm. Restricted Tendering and Single-Source Procurement must be the exception.”

What actually changes
Three moving parts sit underneath the headline about faster tendering.

The first is Commitment Authorisation, a mechanism requiring approval before a procurement commitment is made, so contracts cannot be signed ahead of, or beyond, what the budget allows. It is less glamorous than a timeline cut, but arguably more important structurally, since it is what stops fast procurement turning into fast overspending.

The second is the tightening around Single-Source Procurement and Restricted Tendering, the two routes that bypass open competition. Single-source awards will now be permitted, in the Review’s words, “only in genuinely exceptional circumstances, such as emergencies, national security or where only one supplier is capable of delivering the required goods, works or services.” One line deserves to be read twice by procurement officers across Ghana’s ministries, departments and agencies: “urgency arising from poor planning will no longer be treated as an emergency.” If enforced with any consistency, that closes one of the most persistently abused loopholes in public procurement, engineering last-minute urgency to justify skipping competitive bidding.

The third is the timeline compression itself, described above. Government also commits to sanctions for approvals granted in breach of the Act, and the Public Procurement Authority is expected to publish, by end-June 2027, a report on the value of procurement undertaken by MDAs under each method. That commitment matters more than it looks. It is the accountability hook that will let anyone journalist, auditor, or backbench MP check later whether restricted and single-source procurement actually shrank as a share of total spending, or whether the tightened rules mostly existed on paper.

“Urgency arising from poor planning will no longer be treated as an emergency.”

The legal architecture behind the reform

The 2026 amendment does not stand alone. It sits on legal ground built and repeatedly adjusted since 2003. Competitive tendering has always been Ghana’s default procurement method in law, not only in this year’s policy statement. Section 35(1) of the Public Procurement Act, 2003 (Act 663) instructs that a procurement entity “shall procure goods, services or works by competitive tendering,” except where the Act specifies otherwise. Sections 38 and 40 confine restricted tendering to cases where supply is genuinely limited to a small number of firms and confine single-source awards to a narrow list: exclusive supply arrangements, unforeseeable urgency, catastrophic events, standardisation with existing equipment, or national security. The 2026 reform, in effect, tightens enforcement of a hierarchy already written into Ghanaian law for more than two decades.

The Public Procurement (Amendment) Act, 2016 (Act 914) had moved the other way, restructuring Entity Tender Committees, raising approval thresholds, and introducing tools such as competitive negotiation and framework agreements to ease administrative bottlenecks. That direction continued into 2025, when the Public Procurement (Thresholds for Approving Authorities and Procurement Methods) Regulations (L.I. 2516) revised the same threshold schedules for inflation and market conditions. The 2026 reform lands on ground that has already shifted twice in under a decade: first toward flexibility, then toward recalibrated thresholds, and now toward tighter enforcement of the competitive default Act 663 set out from the start.

Reading the reform from the procurement desk

I have spent the better part of two decades reviewing bid documents, technical evaluations and variation orders in Ghana’s road sector, most recently as Chief Quantity Surveyor within the Ministry of Roads and Highways’ procurement directorate, so I will be direct about where the pressure sits. A twenty-three-week tendering cycle is not twenty-three weeks of administrative drag. Advertisement, bid preparation, evaluation, due diligence and approval routing all sit inside that window, and each step exists because skipping it has historically produced bad contracts. The real question is not whether faster is possible; eight weeks is achievable with an organised process, but whether the same rigour survives the shorter window without being rushed or quietly skipped.

This does not require choosing between speed and diligence. Much of the historical delay in Ghanaian procurement is dead time rather than evaluation time: files awaiting signatures, entities waiting on Ministry of Finance concurrence, advertisement periods extended out of habit rather than need. Used properly alongside the GIFMIS financial platform, the Ghana Electronic Procurement System (GHANEPS) can squeeze out much of that lag without touching the substantive evaluation steps at all. The reform turns risky only if entities respond to a shorter legal timeline by cutting corners in evaluation rather than bureaucracy, since evaluation is what protects value for money and safety. That is a matter of implementation discipline, not something the amended Act itself can guarantee.

A twenty-three-week national tendering cycle is not twenty-three weeks of pure administrative drag; every step inside it exists because skipping it has historically produced bad contracts.

Who gains, and who carries the risk
For contractors and consultants, a shorter, more predictable cycle is unambiguously welcome. Financing costs on tender guarantees and bid bonds accumulate the longer an award decision is delayed, and for small and medium contractors that dead capital can be the difference between bidding again next year or not. Faster award decisions also mean earlier mobilisation, which matters for anything weather-dependent, road construction included, where a delayed start can push an entire season into the next.

For taxpayers, the appeal is straightforward: faster delivery of roads, schools, hospitals and water infrastructure, and, if the single-source restrictions hold, fewer quiet, uncontested awards that rarely produce the best price. For district assemblies and smaller MDAs with thinner procurement capacity, the picture is more mixed. A shorter statutory clock does not automatically arrive with more evaluation staff, and the entities least equipped to move quickly are the ones most likely to feel squeezed into cutting a corner.

The governance risk worth naming honestly is procurement capture dressed up as efficiency. Tighter timelines can, in principle, justify rushed evaluations, shortened advertisement periods that quietly narrow the field of bidders, or pressure on panels to sign off faster than genuine due diligence allows. None of this is inevitable, and nothing in the Review suggests it is intended, but it is exactly the risk that shows up only after implementation, which is why the PPA’s promised report, due by end-June 2027, deserves sustained attention rather than a one-off mention when it is published.

The real test for Ghana will not be whether the legal timelines look competitive on paper, but whether the promised sanctions and public reporting are acted upon when the first test case arises.

Where Ghana’s approach sits internationally

Ghana is not inventing this principle from nothing. The presumption that open competitive tendering should be the default, with restricted and single-source methods reserved for narrowly defined exceptions, is a long-standing feature of the frameworks used by the major multilateral development banks and is reflected in instruments such as the UNCITRAL Model Law on Public Procurement, which most Commonwealth and West African procurement laws, Ghana’s included, draw on in some form. What varies across countries is not the principle but the enforcement architecture around it: how narrowly “emergency” is defined in law, how independently decisions are audited, and how publicly procurement data is disclosed. Ghana’s commitment to publish procurement-method-level data by mid-2027 is a step toward the transparency better-performing systems elsewhere already build into routine reporting, rather than treat as a special disclosure. The real test will not be whether Ghana’s legal timelines look competitive on paper, but whether the promised sanctions and public reporting are actually acted upon when the first inevitable test case arises.

What would make this reform work?
A few things would strengthen the odds. Procurement entities need clear, written guidance, not just the legislative change, on what qualifies as a “genuinely exceptional circumstance,” because ambiguity is where discretion quietly reopens the door the amendment is trying to close. The PPA’s monitoring capacity needs to be scaled alongside the shortened timelines; a faster clock with the same audit resources simply means less time to catch problems before contracts are signed. The sanctions regime needs at least one visible, credible enforcement case in its first year, since rules without consequence tend to be treated as guidance. And Parliament and civil society groups working on public finance should treat the PPA’s 2027 report as a fixed point worth returning to, not a document that quietly slips past.

A cautious verdict
There is a version of this reform that genuinely delivers faster roads, cheaper contracts and fewer quiet single-source awards, and a version that simply moves the old risks into a tighter timeframe where they are harder to catch. The difference will not be decided by the wording of the amended Act, which is sound, but by whether the institutions enforcing it, the Public Procurement Authority chief among them, are given the tools and political backing to hold the line when the first pressure to cut a corner arrives. Competitive tendering as the norm is the right ambition. Making it reality, week after week, contract after contract, is the harder part of the job that starts now.

“Competitive Tendering must remain the norm. Restricted Tendering and Single-Source Procurement must be the exception.”
